How to initialize your teams' workload plan and manage capacity planning?
Intrudction
Collaborator
Management in Abraxio combined with Budget Management and Workload Planning
give you advanced management tools.
Scheduling Collaborator
workloads allows you to precisely manage Projects/Activities from Quotation to
Staffing. Consumption management provides the tools you need to analyse and
update forecasts.
For
managers, it provides global visibility of their Collaborators' Activity and
their Forecast. These elements enable them to take action, anticipate
bottlenecks and exploit optimisation levers.
Finally,
capacity planning provides a high level of control by enabling a real-time
comparison between staffing requirements (MD (Man Day) budget for projects and
activities) and the capacity to cover these requirements (number of days worked
by Collaborators). These analyses can be carried out globally, for internal
and/or external staff, and by profile (macro qualification of
functions/skills). A short-term analysis (3 months) verifies the viability of
planning; a medium- to long-term analysis establishes future recruitment or
service reinforcement needs.
Abraxio
offers the possibility of a global or partial implementation. It is therefore
important to define your management objectives and set up the associated
Configuration elements.
Define your management objectives
4 main management objectives can be achieved with Abraxio:
1. Analyse the time spent on ISD projects and activities
Objectives / Benefits | Management level | Prerequisites and configuration items |
- Record and analyse consumption
- Help update the budget forecast
| - Monitoring of time spent / Monitoring of consumption in days/man
| - Creation of collaborators and periods
- Assignment of employees
- Activate
timesheets to enable Consumption to be entered either by validating timesheets
or by performing a mass import.
|
From the Finance and Management modules, you can analyse consumption in time spent.
2. Analyse
team workloads and requirements by Collaborator profile
Objectives / Benefits | Management level | Prerequisites and configuration items |
- Manage the workload plan for projects and activities to plan and manage them
- Give employees visibility on their forecast costs
- Give managers visibility on their team's workload
| - Management and allocation with or without valuation in €
| Profile
creation: Configuration > Value list > Profiles
Creation of
generic resources (Project Manager, Developer, etc.)
Collaborator
configuration: profile + ADR (Average daily rate) if you want to value in €.
Modify
budget lines to include resources
Quotation
of budget lines
Assigning
collaborators
|
From the

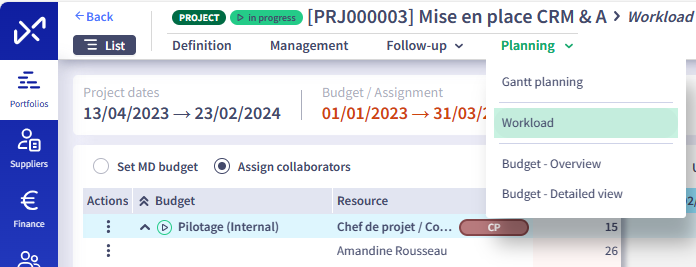

Management module, Workload view, you can analyse the workload by Collaborator.From the
Portfolio module, Workload Plan view, you can analyse the workload by Project
or Activity.
Finally, by
analysing Capacity planning in the Portfolios module, you can get a clear
picture of requirements by profile type. 3. Manage team availability to identify possible understaffing or overstaffing
Objectives / Benefits | Management level | Prerequisites and configuration items |
Plan
Collaborator workloads
| - Availability management
| Management
of assignments (previous point)
Collaborator
capacity configuration: number of days worked per month.
|
From the
Management module, in the Workload Plan view, you can analyse the staffing of
each Collaborator or of a particular team.From the
Portfolios module, you can identify any staffing problems for a given Project
or Activity.
Using
Capacity planning, you can measure whether your needs by profile match the
capacity of your team. 4. Monitor
your Collaborators' remuneration
Objectives / Benefits | Management level | Prerequisites and configuration items |
- Integrate the actual salary of your Collaborators into your management budget
| - Salary
| Configuration
of internal Collaborators with activation of remuneration management and
definition of monthly loaded salary.
Authorisation
to view remuneration items
|
This last
feature enables you to monitor your Collaborator budget so that you don't
double-count your collaborators' remuneration and their assignments valued in €
on your Projects or Activities.
To start
implementing the new features, you need to have identified your Management
objectives in the previous chapter.
The
"Prerequisites and configuration items" column associated with the
selected items will give you a checklist of the items you need to put in place. Profil Creation
Configure the Profile value list. Choose a limited number of profiles. They must remain macro to facilitate their use in capacity planning.
Example :
Creation of generic quotation resources
These generic quotation resources will meet 2 objectives when associated with a budget line:
Define the
skill requirement in the form of the resource label and its Profile
Define the
Quotation chart with the definition of an ADR (Average daily rate).
These
generic resources are to be included in your catalogue of resources for
Internal Profiles and External Services.
Example :
Creation of collaborators
From the Admin/Users
module, you can perform a mass import from an Excel file containing all the
Collaborator configuration elements.
From the
Management module, you can create individual Collaborators or enhance the
qualification of users to convert them into Collaborators.
Collaborator
Configuration
From the
Management module, on the Collaborator file, you must activate the desired
level of Follow-up:
On the
Configuration tab, by Management period, you can fill in the following
information:
Profile qualification
Assignment management
Remuneration Management
On the

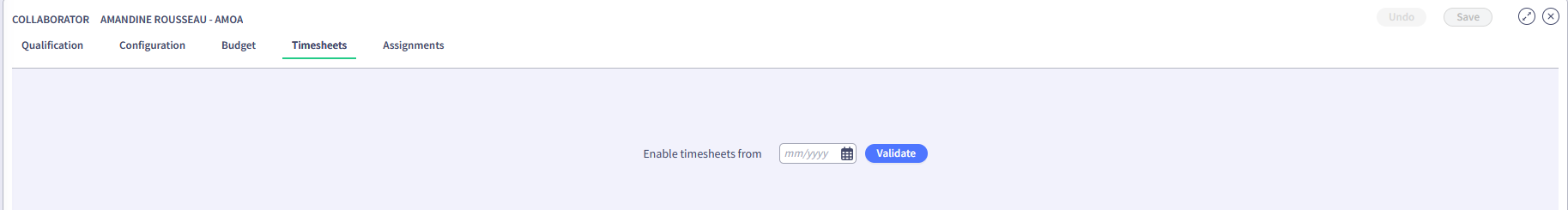

Timesheet tab, you can manage the activation of time recording:
Then, in
the budget tab, fill in the desired elements: remuneration, days worked,
assignment ADR (Average daily rate), etc.
Assignment management
At the
level of each budget line (of Internal Profiles or External Services
categories) in the Finance and Portfolios modules:
the
Qualification tab enables you to establish the Profile/Skill requirement by
selecting a generic Quotation resource, as well as the standard ADR (Average
daily rate) (ADR defined at resource level and which can be overloaded)
the Budget
tab allows you to establish the staffing requirement in MD (Man Day) and the
Financial requirement in €.
the
Assignments tab lets you assign Collaborators and draw up their workload plan,
showing availability and the remainder to be assigned.
Reminder:
depending on your management needs, load assignments are not necessarily
required. However, if you do use this capability, it is important to monitor
the balance line, which is the difference between the defined budget and the
actual staffing.
In the
Portfolios module, you have a specialised view for setting budgets and
assigning Collaborators :
Time tracking
Operation and management
Once in
place, you have several views from which to analyse and take action :
- Management
module, Workload Plan tab: analysis of the workload plan by Collaborator or by
team
- Portfolios
module, Workload Plan/Allocations tab: analysis of the overall workload plan
for projects and activities
- Portfolios
module, Workload plan/Capacity planning tab: analysis of needs vs. capacity by
profile
Related Articles
Workload plan management
Preamble At Project level, the workload plan enables you to : Initially, to establish the staffing requirements in MD (Man Day) smoothed over time and by profile. By adding an estimated ADR (Average Daily Rate), you also obtain a budget valued in €. ...
Employee management
Introduction The purpose of the Management module is to manage teams and Collaborators. As a Team Manager, you can describe your organisation, your teams and your Collaborators. This article describes the various elements of describing and ...
Portfolio management
Preamble The concept of portfolios allows you to organize your many projects and activities to facilitate access and management. You can work with a single portfolio or create several. Generally, a portfolio groups together projects and/or activities ...
Gantt project planning
Introduction On a Project sheet, you can define a schedule. In its minimal form, the schedule will only contain a start and end date for the Project. In an advanced form, if required, it will contain a detailed schedule with Lots, Phases, Activities ...
How to initialize time tracking?
Introduction This article describes the main steps to initialize time tracking for your organisation : Enable time tracking features for your organisation Create teams Create collaborators and add them to teams Activate collaborators time tracking ...
